This is the second part of our first site walkthrough. We're starting from the ground up, or more accurately from the ground down, on a two-to-two-and-a-half-year build of a commercial-spec home with a basement.
A clean slate: demolition and site prep
First job: clearing the site. Almost everything you see is coming out. We have about 2,000 cubic metres of soil to excavate, a pool to drain, and all the existing concrete for our demolition contractor to remove.
We'll try to salvage and sell what we can, but it's often a hard sell, and much of it will likely end up at the recycling tip. The one thing we'll keep as long as possible is the wall next to the neighbour, because it gives us somewhere to run site services during construction.

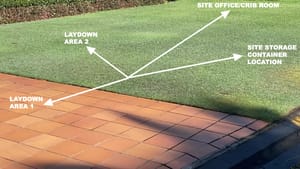

Setting up site services and power

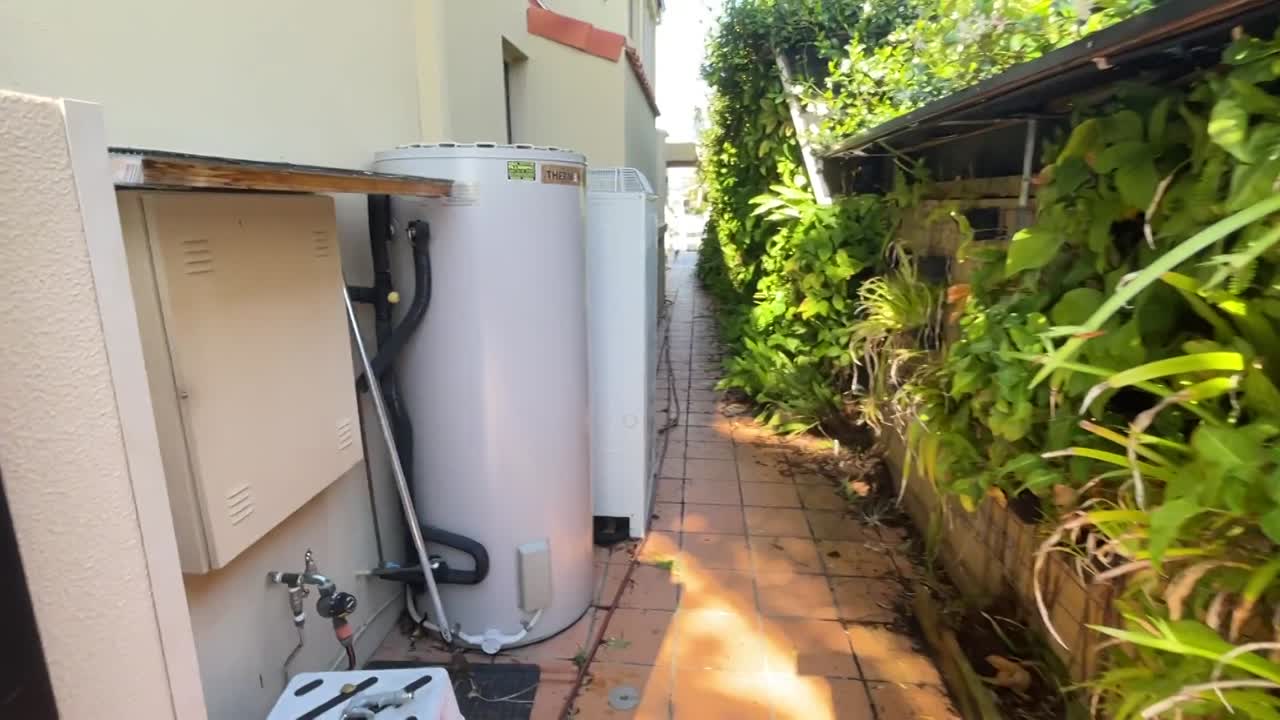

An important early step is organising the new power connection. The existing three-phase supply (three separate supply lines, or phases, instead of the single phase most houses have) has to be disconnected and moved to a temporary distribution board (DB). Ideally that sits close to where the final DB will go, so there's no extra time and work later.
We've already sent preliminary load calculations to the electrician so the new supply is sized correctly. We're aiming for at least 80 amps per phase.
As a side note, the house is designed to be self-sufficient with mains power as backup: enough solar, batteries and generators to run off-grid if needed. A house this size is expensive to run, so spending on this at the design stage (budget permitting) cuts running costs for the life of the home.
We also need to keep a 15-amp shore power connection and a temporary water supply down at the jetty, so the owner can still go fishing, wash down and flush the boat engines, and keep the boat's batteries charged. All these services will run along the retained wall for the whole build.
The basement: waterproofing is everything
The most complex part of this project is the basement. Groundwater sits just 1.6 metres below the surface, and the basement floor sits below that. So we need a full hydrostatic slab: a basement floor designed to resist water pressing up from underneath.

Water pressure goes up by about 10 kPa (kilopascals) for every metre you go below the water table. An empty basement behaves a bit like a boat: the groundwater pushes the walls inward and the floor upward. The structure has to be heavy and strong enough to resist that, and the waterproofing has to have no gaps, or that pressure will find them and you get damp, mould and leaks.
So we're planning a multi-layered system:
- Sheet piling: steel sheets driven into the ground about 600 mm off the neighbour's fence. They hold back the soil and water while we dig and create a safe working space. (In the end, most were pushed in by a heavy rig after pre-drilling, with vibration only for the last metre. See Post 30.)
- Dincel walls: we'll likely use Dincel (a permanent polymer formwork that is filled with concrete) for the basement walls instead of concrete blocks. Blocks are porous, so a block basement relies entirely on its membrane. A Dincel wall gives a continuous concrete core with fewer joints and more mass.
- A full “pig in a blanket” seal: the whole structure is wrapped in a SikaProof A+12 membrane. It's laid on a blinding slab (a thin layer of concrete that gives a clean, flat base), runs under the basement slab and wraps up the outside of the basement walls, creating one continuous watertight barrier.

The engineer's coordination drawings later confirmed the shape: 200 mm Dincel walls standing on a thickened edge of the 250 mm raft slab (900 mm wide and 500 mm deep), all sitting on a concrete blinding layer.
The yellow line in the sketch is the part that matters most. Every joint in the membrane is lapped and sealed, and it has to stay undamaged until the concrete is poured against it. A single tear below the water table can let water in, and once the slab is poured you can't get back to it.
Water pressure also decides how long the dewatering pumps have to run. We come back to that in Post 31, where it added weeks to the program.
The team and the timeline
This isn't a standard residential build. Although it's a Class 1a house (a standalone home under the National Construction Code), we're building it to commercial specifications, with a suspended slab and roof.
We have a full team of consultants: structural, mechanical, electrical, geotechnical and hydraulic engineers, plus an architect, building certifier and town planners. We're also about to engage a specialist pool engineer.
We're currently waiting on Development Approval (DA, the council's planning approval) while finalising the water management, vibration management and retention plans. Once those are done, we can get early works building approval (approval to start retention and excavation before the rest of the design is finished) and start digging.
If you’re planning a basement
- Get a geotechnical report early and look for the groundwater level. If it's above your basement floor, you need a hydrostatic design, not just a membrane.
- Ask which waterproofing system is proposed, who installs it, and who warrants it. Systems that are installed and inspected together are easier to hold someone accountable for.
- Ask your engineer how long dewatering has to run. It's billed weekly and is often the biggest unknown in a basement budget.
We'll keep posting regular updates and videos, from the first excavation to the final finish.
