A couple of things I forgot to mention in the earlier posts. So far we've focused on site planning, and this one covers how the site itself will be set up.

Keeping part of the driveway

For the demolition phase, we'll keep most of the existing driveway. The sewer main is in an awkward spot, right inside the boundary and about 1.3 metres down (see Post 2), but we can't change where it is, so we work with it.

We'll keep the driveway up to a certain point and saw-cut it there. The part we keep becomes a hardstand: a firm, level base for concrete pumps, cranes and other equipment.

The retained driveway slab gives pumps and cranes a solid base for their outriggers
The retained driveway slab gives pumps and cranes a solid base for their outriggers

Pumps and cranes stand on outriggers, legs that push out sideways and spread the machine's weight through pads onto the ground. If the ground under a pad is soft, the machine can tilt or tip. A sound concrete slab gives the operators a safe base without us building a new platform. The rest of the area will be demolished to make room for the basement and the working space around the outside of its walls.

It might seem like a small detail, but we spent a lot of time planning it.

Site office and storage on council land

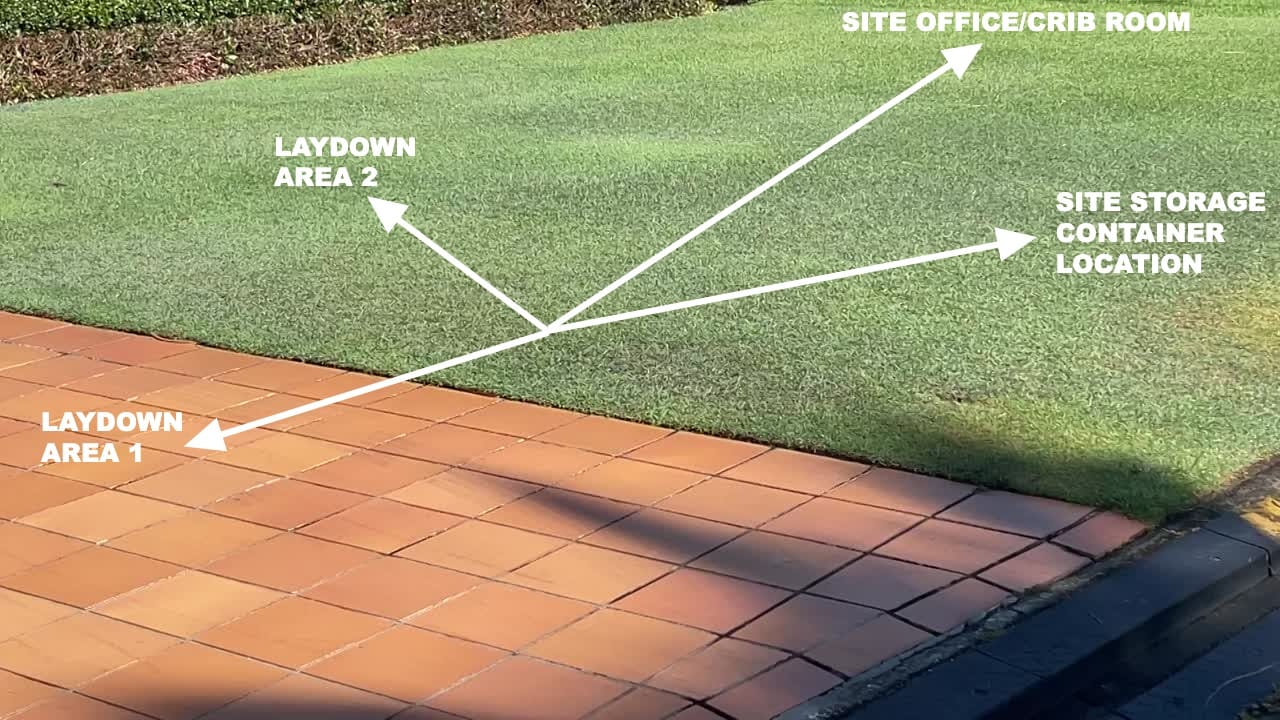

We have a minor work zone permit application in with council for the grassed area out the front, which is council land (the road reserve). We'll run temporary fencing across this whole section to isolate the site, and set up a 9 m by 3 m site office here, along with a 20-foot container for storage.

Because this setup is on council land, we pay rent for it. The application needs a traffic management plan (TMP) and traffic guidance scheme (TGS), even on a residential street without footpaths. Council charges a monthly fee based on the area used, and permits are granted for three months at a time, so we'll reapply for a second term. We expect to need the space for about six months, at a total cost of around $10,000.

Once the basement and first-level slab are complete, essentially once we're out of the ground, we'll move the site office and storage into the basement. That lets us hand back the council space and off-hire the temporary facilities, which are expensive.

Security

Security is a top priority for this site. We'll have several cameras at both the front and back of the property, connected to our phones so they send movement alerts around the clock. External security will monitor the site as well.

Amenities for the trades

The site office will be air-conditioned and double as a crib room (the site lunch room), giving contractors a comfortable place to take a break, get out of the heat and have lunch. We'll fit it out with a fridge, microwave and coffee-making facilities. A shade structure and a cold water fountain will also go in, with more fountains as the workforce grows.

You might remember the stainless steel teppanyaki-style barbecue from an earlier post. We're moving it and building a small enclosure so we can host Friday barbecues for the trades. Bacon and egg rolls always go down well, and it's a nice way to start the last day of the week together.

A proper toilet

Finally, and most importantly, the toilet. Instead of a chemical toilet, we'll build a small platform and connect directly into the existing sewer line. It's a much cleaner solution with no pump-outs. It needs a licensed plumber and approval from the sewer authority, so it isn't a DIY job.

If you've ever been near a pump-out truck first thing in the morning, you'll know how unpleasant the smell can be for neighbours. This approach is better for everyone.

That's the full initial site setup.
