It's been about two weeks since the sheet piling finished, though it feels longer. We've been busy with site housekeeping, fence building and some decisions about what comes next.
Every site has its quirks, and this one has groundwater, a boundary wall to demolish, and ground that's been well and truly disturbed by the piling.
First job: make it safe
Before any excavation, we needed a temporary fence so nobody could wander into the hole once it's dug. We built a basic timber fence from rough-sawn green pine, bolted it through the sheet piling and screwed the battens on. Nothing fancy, but it does the job.
Taking down the old boundary fence
The existing fence between us and the neighbour was about 40 years old, and it was time for it to go. First we put up a temporary fence on their side with two layers of shade cloth for privacy. Not perfect, but better than one layer.

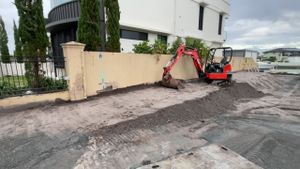

Then came the dangerous part. We brought the excavator in, broke the first section, grabbed the rest with the bucket, and the whole thing came down in one go. That's what we'd hoped for, but we weren't sure it would work until we tried.
An engineered footing
We're installing tilt panels between the two properties. The company that makes them wanted to use their standard footing detail. We said no.
The ground here isn't standard any more. Pre-drilling for the sheet piles disturbed the soil in a radius of about 1.5 to 2 metres, which changes its density.
Tilt panel fencing companies usually have one standard engineering detail, designed once and reused on every job. That's efficient, but soil and groundwater vary from block to block, and a standard detail only suits certain soil conditions.
My advice: ask the tilt panel company for their panel engineering upfront. Take it to your structural engineer and have them design a footing or pier for your geotech report. Then you know the foundation is built for your site, not someone else's.

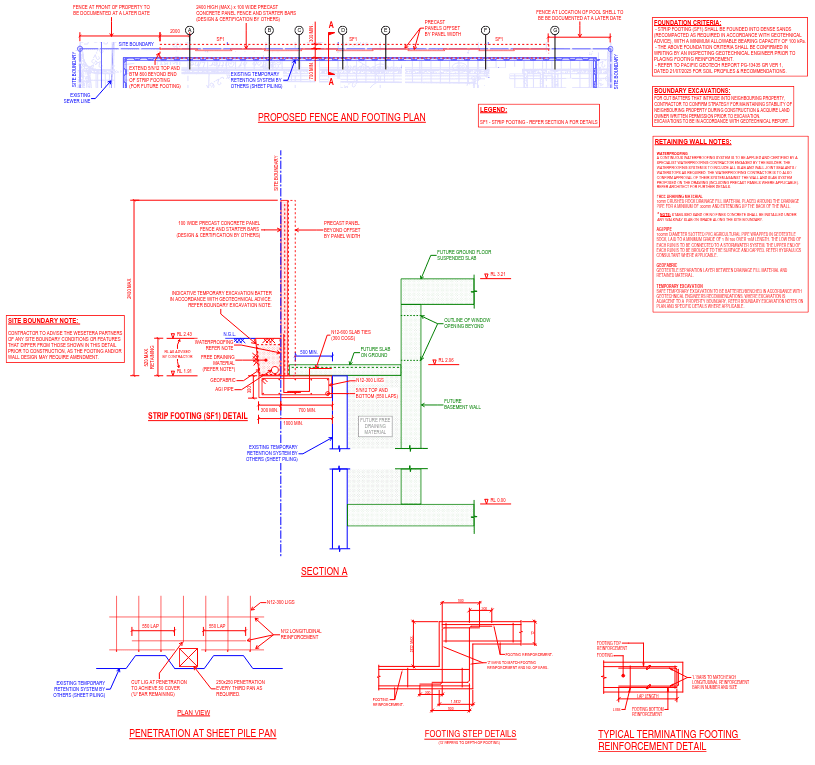

So our engineer designed one for us:
- 1 metre wide and 300 mm thick. That's a decent size for a fence.
- Steel reinforcement: five bars top and five bars bottom, with ligatures every 300 mm.
- It extends slightly under the boundary line to give enough weight to resist wind load.

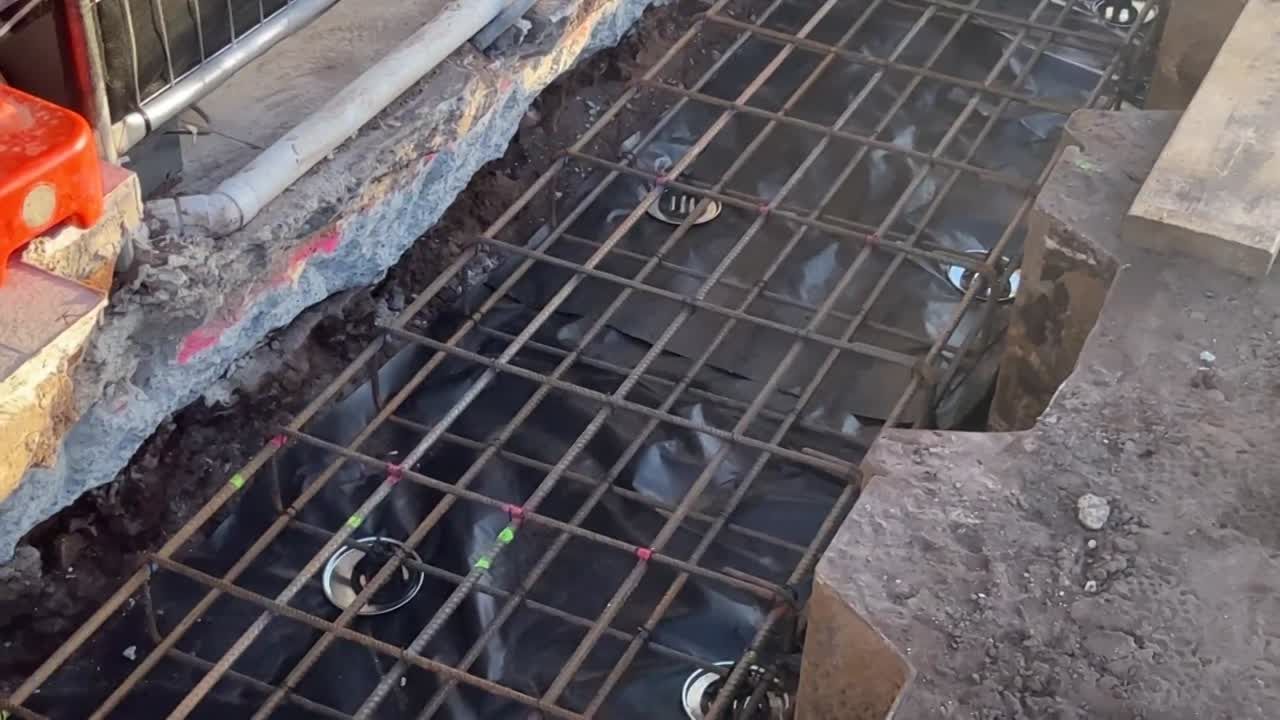

We made the steel cages on site and hand-dug the trench. These panels are heavy, and if a big wind hits them side-on, the footing has to hold.

Levelling the path and other details
Once the engineer has inspected the steel and signed off, we'll pour. The trucks will reverse right up to the edge and pour straight from the chutes, which saves on pump hire.
There's another issue. The sheet piling has caused the path alongside the house to drop 55 to 75 millimetres. We're going to underpin it off the new footing, jack it back up to level, and pack it with high-strength concrete about every 1.8 metres.
We'll also need to sort out the tile line along the boundary. It's an overlap panel system, so there'll be a gap on one side. We'll sit down with the neighbours and decide whether to cut a straight line through the tiles, replace them, or put in a drainage grate, whichever looks best and works.
While we were digging, we also undermined a couple of the neighbour's trees. We lifted them out carefully with the excavator, replanted them further back, and engaged an arborist to inspect them and set up a nutrient program. Hopefully they settle in. If not, we'll replace them and make good.
Dewatering
You might have noticed the Formatubes (cardboard tube forms) in the footing. They leave 300 mm voids so we can install spear points for dewatering later. The spears draw the groundwater down so we can excavate the basement safely.

A conversation with our structural engineer yesterday changed our timeline: we can't pull the dewatering system out until the ground floor slab is poured.
The basement slab and walls aren't heavy enough on their own. If we turned the dewatering off too early and a big storm came through, the groundwater pressure could push the slab up off the ground. That's a real risk, not an exaggeration.
So we need the ground floor slab in place to add 22 kPa (kilopascals) of downward force: enough weight to hold the basement down against the groundwater pushing up. Only then is it safe to switch off the dewatering. We explained how water pressure builds up below the water table in Post 6.

Dewatering runs at about $7,700 a week, and with the system running an extra 10 to 12 weeks, we're looking at another $70,000 to $80,000. We'd budgeted for some of it, but it still stings. It's still far cheaper than fixing a slab that has lifted. If you're planning a basement on a high-groundwater site, ask your engineer early how long dewatering must run. It can be the biggest unknown in the budget.
Once the system's installed, it gets primed and flushed. Then comes the water testing. That's when we find out two crucial things: the size of the filtration plant we'll need, and how much flocculant (the chemical that treats the water) we'll be using.
If iron shows up in the water, we'll need additional filtration equipment on top of everything else (see the article below). Plus, we'll have to bring in a vacuum truck weekly to remove sediment from the filtration tanks. It all adds up.
Iron and Acid Sulfate = red staining. Note: the fine is $17,000/day until remedied.
The paperwork in the background
While the fence and footing work has been going on, the approvals have kept moving:
- The build-over-sewer application is in. We need to update a few plans for council, which needs a Quality Level B survey (one that accurately locates underground services).
- Plumbing and drainage approval has come through.
- The civil engineering documents are with council for operational works approval.
- We're waiting on the structural engineer to finish their design, which they say will take two weeks.
Once we have the Form 15s (the engineer's design certificates the certifier needs) for the basement slab, walls and excavation, we'll bundle everything up and send it to the certifier for building approval.
There are also some minor changes from the interior designer and the client, but we're holding those until the engineer finishes, so their timeline doesn't slip further.
What's next
New materials have arrived to continue the safety fence down the side of the property. That will let the owner get to the back and the boat safely once excavation starts.
Then we'll pour the footing, fix the path, and keep working through the approvals.
There's always more to do than time in the day, but it feels good to be making progress. I'll keep you posted.
