This is a Saturday update from 31 January 2026. Our last post was on Tuesday, and a lot has happened since. As of Friday afternoon, demolition is officially complete. The last bin, full of some seriously chunky concrete, is about to be hauled away.

The old footings were massive for a house. Most likely the trenches caved in during the original dig, and instead of shoring them up, the builder poured more concrete to fill the void. That explains the extra weight. The remaining rubbish and the skip will be gone on Monday, leaving us with a blank canvas.

Footings, cover and the membrane

The old footings are a good excuse to explain two things that matter on any new slab.

Overbreak is when a trench is dug wider or deeper than designed. Under AS 2870 and AS 3600, a bigger footing still needs reinforcement that suits its new size, and the concrete cover (the concrete between the steel and the ground) still has to be kept. Cover is what protects the steel from moisture and rust. Footing concrete must be at least 20 MPa, and often more, depending on soil acidity, the site's exposure classification or uplift loads.

The damp-proof membrane (often called the vapour barrier) is the plastic sheet under the slab. Where a slab-on-ground has habitable rooms above, AS 2870 and the NCC Housing Provisions require a 200 µm (0.2 mm) membrane under the entire slab and footings, turned up the edges of the slab and edge beams.

A slab edge beam in section: membrane under the slab and up to ground level, steel held on chairs to keep its cover
A slab edge beam in section: membrane under the slab and up to ground level, steel held on chairs to keep its cover

The demolition team has been track rolling (compacting the soil with the excavator tracks) as they go, even though most of this area will be dug out for the basement. We have about 2,000 cubic metres of soil to remove.

Securing the site and a few fixes

On Friday we started putting up temporary fencing at the rear. Hoarding and sediment control fencing are coming soon to keep everything safe and contained, and we've made them easy to remove later with simple bolts.

The site is fenced and signed to keep people out. We also had to get creative with the old jetty. It was sitting on a slab, so we lifted it with an excavator and refixed it so the concrete path could come out.

One of the hinge pins was rusted solid and had to be cut off with a grinder, so we'll remake that part later. For now, the jetty is propped on blocks and temporarily fixed in place.

Temporary power and the site camera

Our temporary power needed a touch-up. The electricians hadn't glued the conduit bends, saying it was "only temporary". For a two-year project it needs to be more robust, so we went around and glued all the joins so they'd stop pulling apart.

We also had to move the site security camera. After pulling out the old stairs (which were pinned into the wall), we noticed the camera pole starting to lean out of plumb. We used the small excavator to move it, a three-person job, and re-bolted it to a solid section of wall.

Then came the fun part for me: running new data cables in orange conduit, terminating the connections and testing it all. I might talk about data cables a bit much, but I enjoy it.

A snag, and a new barbecue station

As often happens at the end of a long day when everyone is tired, we had a small mishap. The 25-tonne excavator just clipped one of our awnings and wrecked it. It's beyond repair, so it comes down on Monday.

On a brighter note, we built a simple barbecue station on Friday. A bit of form ply and some treated timber on hinges gave us a fixed spot for the barbecue with a small serving area. A small comfort for the team on site.

What's next: council and finishing the designs

With the house gone, the focus shifts to paperwork. We're finalising the Development Approval (DA, the planning approval from council). Council wants a specific letter about the coastal revetment wall (the seawall protecting the bank) before they issue the approval.

Getting engineers to sign off on something before their design is finished is tricky, so it's been a slow three weeks. But I'm optimistic after a good meeting with our geotechnical engineer, who knows the council and is willing to help. Once we have the DA, we can:

  • Submit any operational works conditions to the civil engineer.
  • Finalise the hydraulic and structural designs, and their crucial Form 15s (the engineer's certificate that the design complies).
  • Gather insurance documents and submit everything to the certifier for Building Approval (BA, the approval to build from the private certifier).

Then we can finalise quotes for the sheet piling and dewatering (pumping out groundwater so the basement can be dug). Programming this tightly is critical: dewatering is expensive, and if we're not efficient the cost can rival the sheet piling itself.

And it's gone

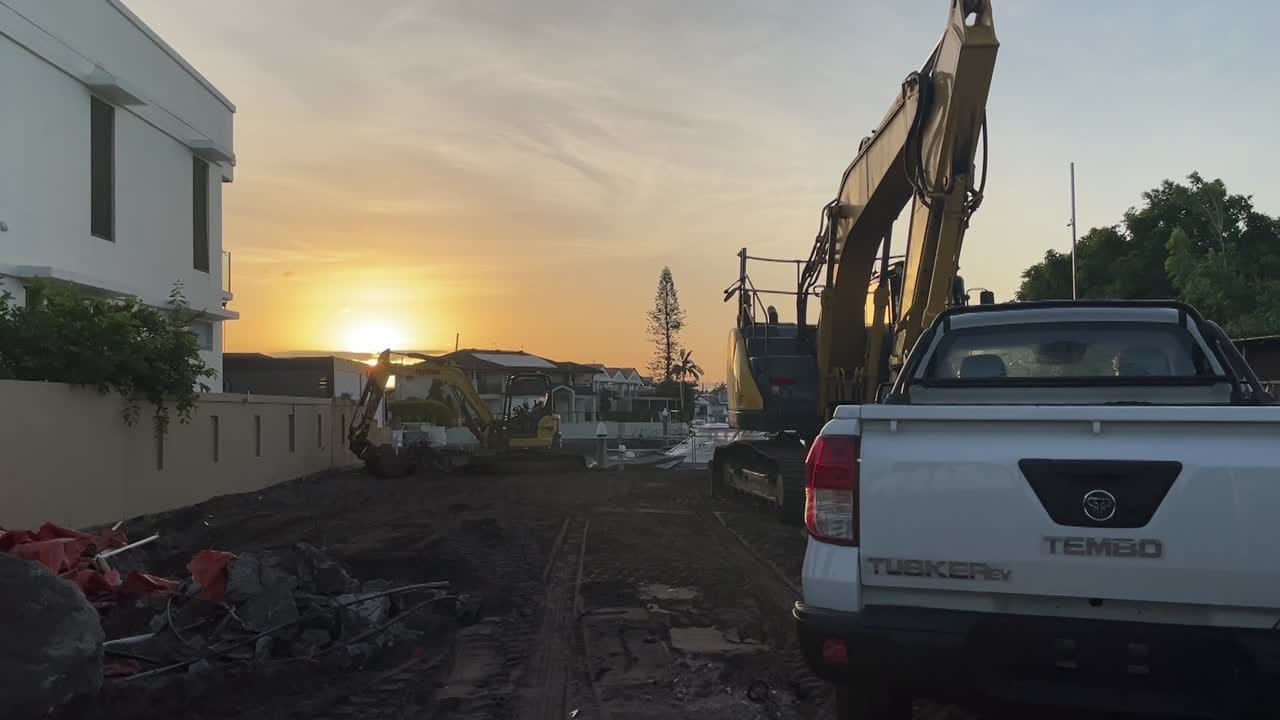

What started as a 35-year-old two-storey house is now a vacant site, ready for its next chapter, all in 18 days.

Thanks for following along. More updates next week.
