Since the demolition finished, the site might look quiet, but we've been busy getting it properly set up for the build.

The site office was delivered today, and tomorrow a crane lifts it into position. Before that, we needed reliable internet.

I tried a 4G MIMO antenna first, but the signal was weak: just 25 Mbps. Then we installed Starlink, and speeds jumped to 185 to 250 Mbps. The palm tree blocks part of the satellite's view, but it's still about 10 times faster than 4G. For a site office, it's made a big difference.

Fencing, awnings and a few fixes

The temporary fences (expensive ones) kept breaking in the wind. Instead of buying $30 braces, we made our own.

We also added awnings to the container. We roll them out during the day and in at night, so they don't flap around. We bought the container rather than renting it, which means we can drill holes in it. If you rent one, don't drill it, or you'll be paying for it at the end of the hire.

Surprises underground

While digging near the comms pit, we found the incoming data cable pinched under a footing instead of running through conduit. That probably explains the previous owners' internet problems. We dug it out carefully, cut the cable nearby and pulled it back into the pit.

We were careful because cutting the street's internet is a quick way to make enemies, especially with Telstra. Cables in the street belong to the carrier, so always lodge a Before You Dig Australia request and check with the carrier before you touch anything that isn't yours.

We also uncovered and capped off old stormwater and sewer lines. That should have happened earlier, but concrete and rubble were in the way. The lesson: find out what's underground before demolition day.

Fitting out the container

Before the new office goes up, the storage container got an upgrade:

  • A mini kitchen: microwave, fridge and coffee machine
  • A printer on Wi-Fi through the Starlink router
  • The pressure cleaner, vacuums and the usual tools
  • A chandelier (it's going into the new house) and a Sonos speaker
  • A ceiling fan to make the heat bearable

For lighting, we skipped $100 LED fittings and used 5 metres of LED strip in a channel: about the same price for far more light. Thanks to our local Ideal store for friendly, old-school service, and better prices than the big hardware chains.

Security cameras and the network

In short, six PoE cameras (power over Ethernet, so one cable carries both power and data) and a siren all run back to a UniFi video recorder, which connects to the internet through Starlink. For the network nerds, here's the detail:

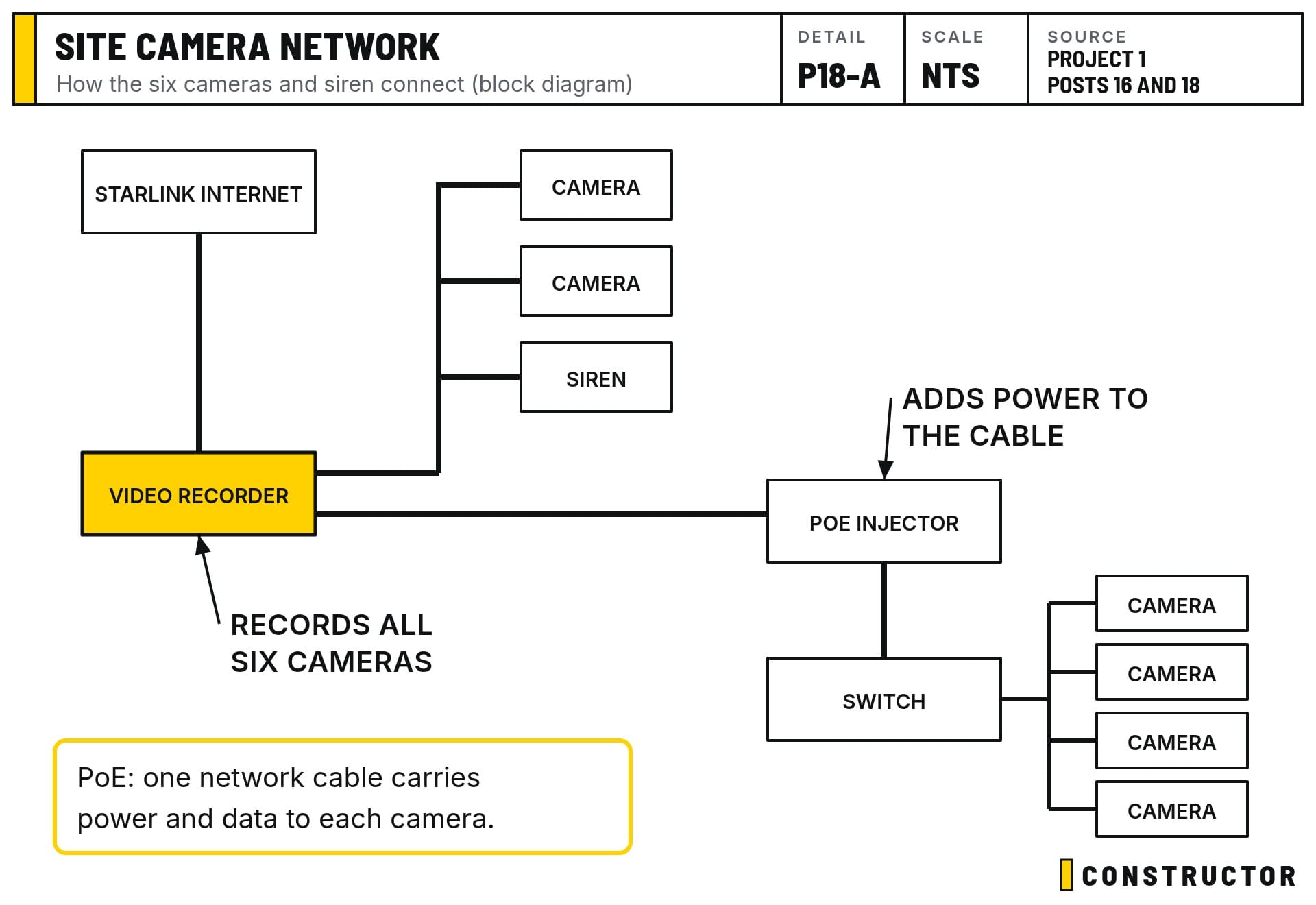

The site camera network: Starlink, the video recorder, a PoE injector and switch, six cameras and a siren
The site camera network: Starlink, the video recorder, a PoE injector and switch, six cameras and a siren
  • Starlink feeds a UniFi UNVR (the video recorder), and the Starlink's built-in router runs the site office Wi-Fi. If coverage is poor, we'll add a Starlink mesh router and move the UNVR onto its network port.
  • Four PoE cameras connect to a UniFi Flex switch, which connects to a UniFi 60W PoE injector.
  • The 60W PoE injector connects to the UNVR.
  • A UniFi PoE siren connects to the UNVR.
  • Two more UniFi cameras connect directly to the UNVR.
  • That's six cameras in total, the maximum for this UNVR.
  • The electrician installed four 15-amp power points and a sub-board.

We also added a lockbox for padlocks and a sprinkler system on a timer for dust control. Programming the timer took three days, until I found winter mode had been switched on by accident. Holman's help article sorted it out. When in doubt, read the instructions.

Marking out the house

Matt spent today marking out the house grid in fluorescent paint, from the architect's early works pack. The whole house is designed on a grid, so everything is set out from the same lines.

We've pegged all the corners and the basement walls, and you can see the footprint taking shape. The good news is that we only need to dig another 1.4 metres to reach basement floor level, which is less soil to move than we expected.

We also asked the structural engineer whether we really need the second basement wall closest to the boundary, given the sheet piling there is sacrificial (it stays in the ground for good but isn't counted as part of the permanent structure). The answer was yes: that wall acts as a retaining wall. Without it, the other basement wall, about 1.2 m from the boundary, would need to be 275 mm thick. We left the design as it is, because we need the structural design finished. If you're building close to a boundary, expect retaining questions like this to affect both your design and your cost.

What's next

Tomorrow the crane lifts the site office into place. Then we build stairs, with a landing and handrail, to get up to it, without crossing the property boundary (council "friendships" are expensive).

Until the sand comes out, the sprinklers run four times a day to keep the dust down. We also have two fully electric utes on site, which are quiet and handy for site runs. More on those later.

Right now it's all site establishment, so the build itself runs smoothly.
