On most project homes I've worked on, the build doesn't wait on the slab or the frame. It waits on one thing: the next trade being free, the next inspection being booked, or the next decision being made. That one thing is a constraint, and Eli Goldratt's Theory of Constraints (TOC) is about finding it and managing around it.
If you're building, this matters because every week your house sits idle is a week of rent, interest or bridging finance. Understanding where the bottleneck sits helps you ask better questions and avoid becoming the bottleneck yourself.
What the Theory of Constraints says
Think of a chain. It's only as strong as its weakest link. A building program works the same way: it can only move as fast as its slowest step. Speeding up everything else doesn't help.

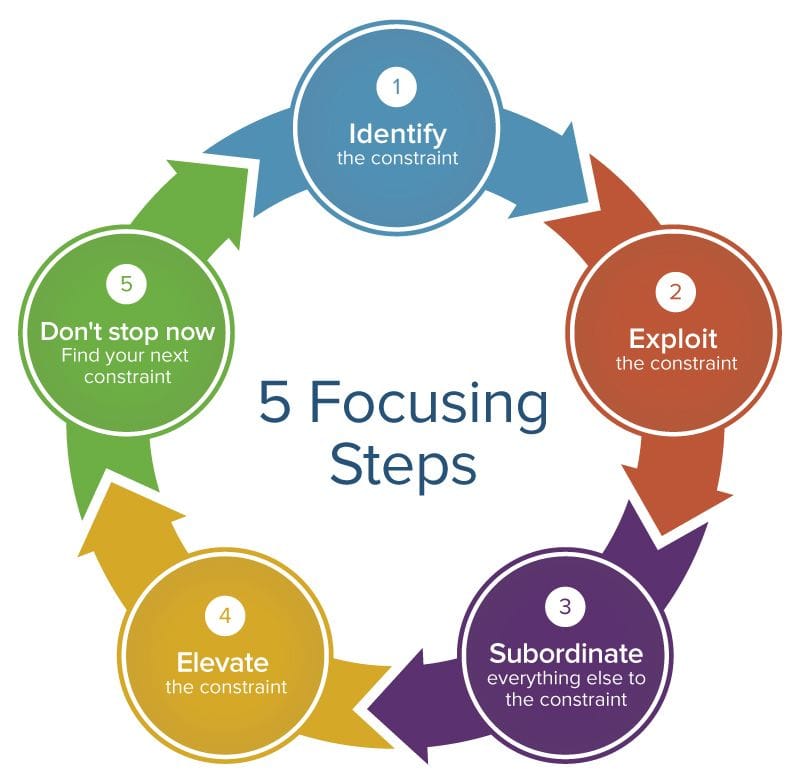

Goldratt set out five steps:
- Identify the constraint.
- Exploit it. Get the most out of what you already have at that point.
- Subordinate everything else to it. Line up the other work so the constraint is never left waiting.
- Elevate it. Add capacity or remove the bottleneck.
- Repeat. Once one constraint is fixed, another becomes the slowest link, so go back to step 1.
Why fixing everything doesn't work
Traditional process management tries to improve every step. TOC says most of that effort is wasted, because improving a step that isn't the constraint doesn't finish the job any sooner.
Speeding up the painters doesn't finish your house sooner if the job is still waiting on the cabinet maker. The painters just end up waiting longer.

What it looks like on a building site
On a residential build, the constraint is usually one of these:
- Trade availability. In a busy market, a good plasterer or tiler might be booked weeks out. Every job in the builder's program queues for the same people.
- Materials. Late roofing, windows or frame packs stop everything behind them.
- Inspections and certification. Slab, frame and final inspections have to be booked and passed before the next stage can start.
- Wet weather. Earthworks, slabs and roofing can't proceed in heavy rain, and a wet week in summer can push the whole program.
- Decisions. Late selections, slow variation approvals and changes of mind are some of the most common delays I see, and they're the ones the homeowner controls.

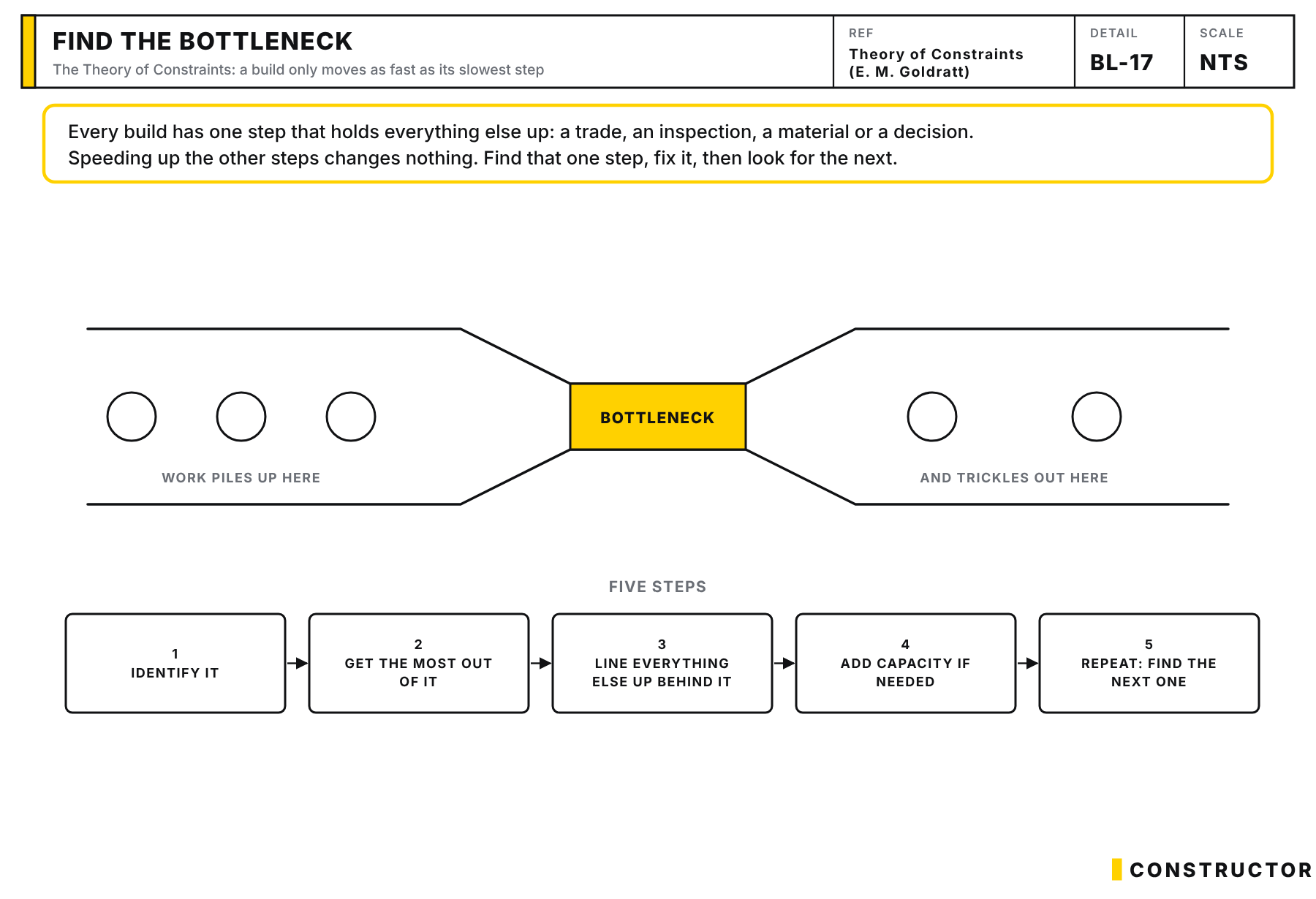

Say roofing materials are the bottleneck. A builder applying TOC would make sure the roofer has everything else ready to go the day the sheets land (exploit), schedule other trades so they're not stuck waiting on the roof (subordinate), then look for a second supplier for the next jobs (elevate).
Mapping the whole job

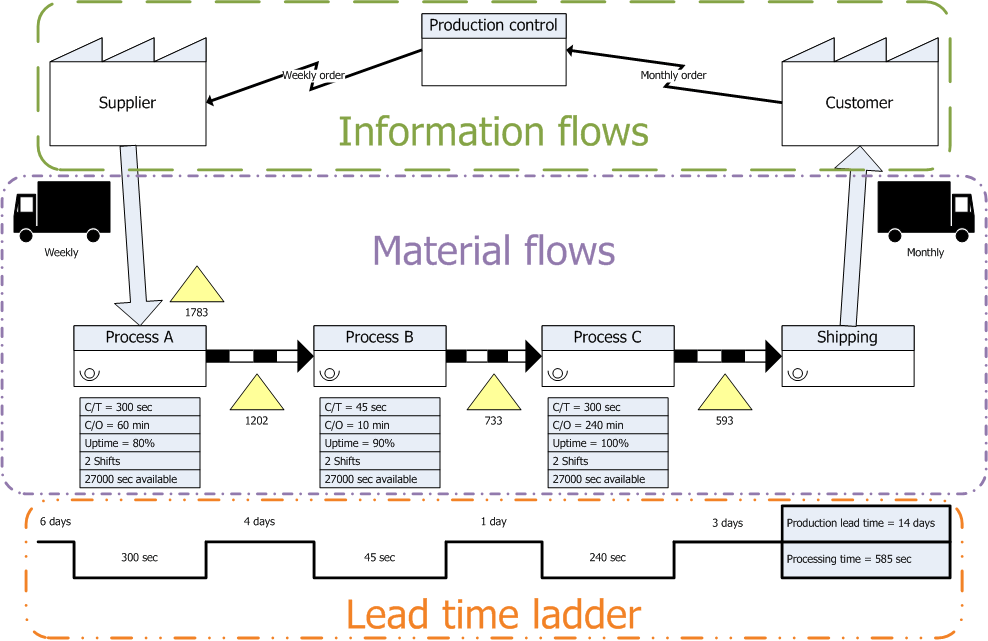

Value Stream Mapping is a useful companion to TOC. It lays out every step in a process, from site start to handover, and shows where value is added and where work just sits and waits. Once you can see the whole stream, the bottleneck usually stands out. On many jobs it's not the physical work at all. It's the paperwork, the inspection booking or the decision nobody has made yet.
Good builders run their jobs with clear stage gates and hold points for exactly this reason. I've written more about that in stage gates and ITP processes and in why agile project management works (or doesn't) for house building.
What you can do as a homeowner
You can't fix a tiler shortage, but you can stop your job becoming the constraint:
- Make your selections on time. Finish colours, tiles, fittings and appliances by the date your builder gives you. A late selection can hold up ordering for every trade behind it.
- Approve variations promptly. If a variation is fair, sign it quickly. If it isn't, raise it straight away in writing rather than sitting on it.
- Ask what's on the critical path this month. A good supervisor can tell you what the job is waiting on right now and what's next.
- Book your own inspections early. If you're using an independent inspector, book them ahead of each stage so they don't hold up the next one.
- Pay progress claims when they're due (once the stage is genuinely complete). Late payments can push your job down the builder's priority list.
- Keep a short list of questions for each site meeting so decisions get made on the spot.
Before you even sign, it's worth asking a builder how they schedule trades across their jobs and how they handle wet weather. The answers tell you a lot. Our checklists, especially C4 Asking the Right Questions, give you a structured way to do that.
The bottom line
TOC is really a habit of asking one question: "What is this job waiting on right now?" Ask it at every site meeting. If the answer is you, fix that first.
