Once the slab is poured, every pipe under it is buried for the life of your home. Here’s what to check before that happens.
Under-slab water lines, waste lines and the sewer connection must be set out accurately on undisturbed soil (natural ground that hasn’t been dug out or filled), sealed where they pass through a clean moisture barrier, and kept clear of the mesh and reinforcing.
Timing is everything: tidy planning first, then careful pre-pour inspections (our checklists are pretty thorough), and finally a calm, controlled concrete pour that doesn’t knock anything out of place.
Why so much attention? Because under-slab mistakes can be expensive and disruptive.
A pinched water pipe can drop water pressure through the whole house, a flat section of drain (DWV: drainage, waste and vent pipework) can cause repeated blockages, and a missed sleeve can lock a fixture into the wrong spot. Worst case, you’re looking at slab leak repair later. Fixing any of that costs far more than preventing it.
This guide takes you from planning through to the pour: how the system works, how to inspect it, what’s realistic to fix on the day, and where your plumber adds real value.
C5 - Pre Pour Slab Inspection Checklist
$119.00 AUD
Last updated 28 Oct 2026 · Revision 4 · Free updates for life
Checklist Type: Major (Base Stage)
Form Factor: Fillable, print-ready PDF (A4, 30 pages)

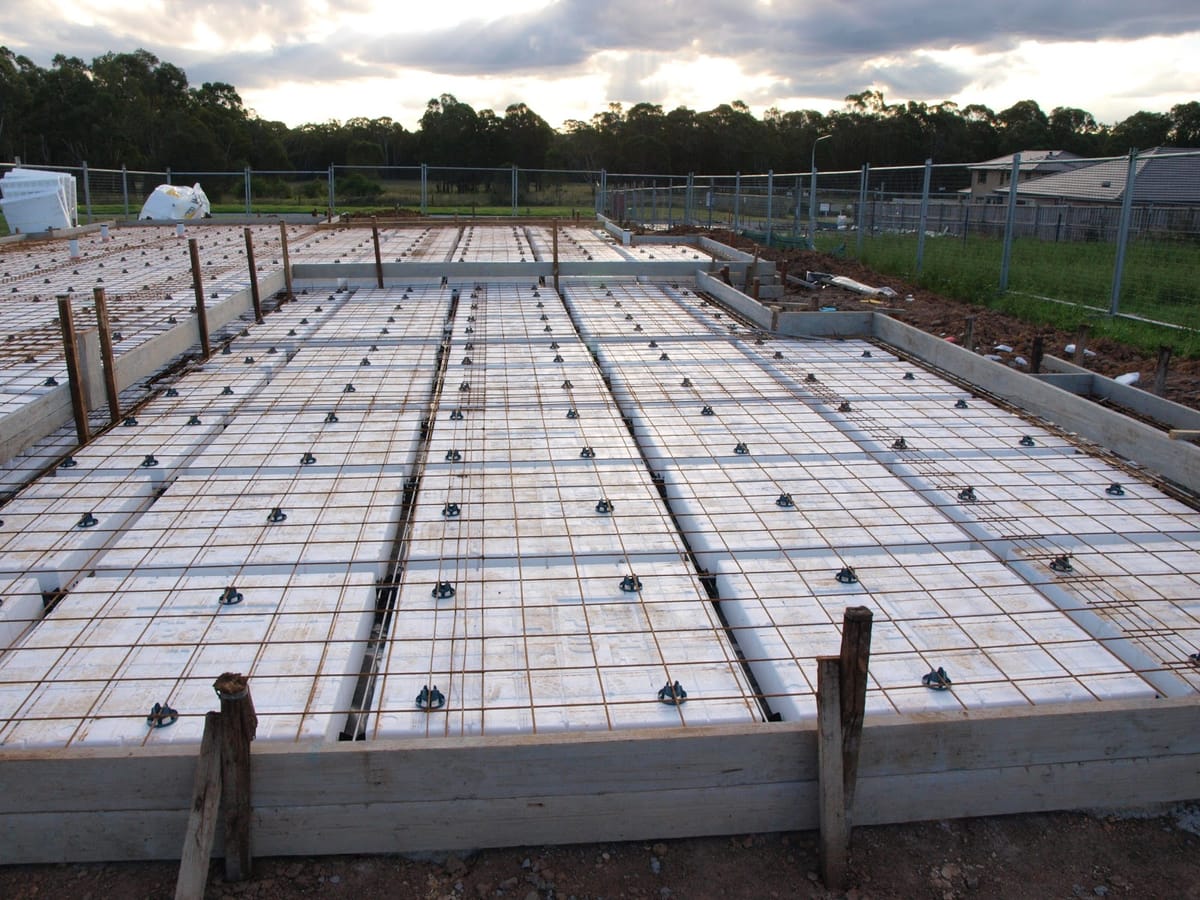

When to use: Base stage: after the slab is prepped, before concrete is poured
A 95-point pre-pour slab checklist. Check setbacks, boxing, membrane, pipes and steel after the slab is prepped and before concrete is poured, while fixes are still simple.
How under-slab plumbing works
Under a concrete slab foundation, the plumbing system splits into two main streams:
- Water supply: pressurised water lines (cold and sometimes hot pre-runs) feed future fixtures. These are typically water pipes in sleeves or lagged where they pass through beams or thickenings, so movement in the slab doesn’t rub or crush them. The system’s water pressure is what makes taps run; any kinks or compressions from reinforcing or the pour can cause issues later.
- Drainage (DWV): waste lines carry wastewater via gravity to the main sewer line. These must maintain continuous falls, connect via correct junctions and bends, and provide inspection openings at sensible points. Good layout prevents gurgling, smells, and recurring blockages.
On a typical new build, the under-slab runs have to be coordinated with slab beams, thickenings, pods/void formers (the polystyrene blocks that shape a waffle slab), set-downs and reinforcing (mesh and bar). Everything sits on compacted bedding on undisturbed soil, covered by a taped moisture barrier (vapour barrier) before the pour. That barrier keeps out damp and lets the termite protection tie in neatly.
Why it matters: mistakes here get buried. On top of the pressure and blockage problems above, bad sealing around penetrations compromises the moisture barrier and termite protection.
Planning & layout: the first thing to get right
The first step: drawings, set-outs, and coordination
Before anyone touches a shovel, confirm:
- Latest plumbing system drawings match the slab design (beam layout, ribs, set-downs).
- Fixture positions align with cabinetry and tiling set-outs.
- Penetrations have sleeves/lagging specified, especially where water pipes cross thickenings or movement joints.
- Allowances for a waste pump (if the site needs lifting to the sewer) are shown with power and maintenance access.
Falls and fixture logic
- Set correct falls for waste lines (too flat = blockages; too steep = solids left behind). Under AS/NZS 3500.2 the usual minimum for a 100 mm drain is 1.65% (about 1 in 60).
- Keep junctions clean, with minimal direction changes; plan sewer line routing to avoid clashing with ribs and starter bars.
- Place inspection openings logically—at changes of direction and line ends.
Services and structure
- Keep pipes clear of wire mesh and rebar (no contact points).
- Avoid running through ribs or thickening beams unless engineered and sleeved.
- Mark every penetration on the slab set-out—this is the first thing the foreman and plumber verify together.
Materials & components
- Water lines (water pipes): copper or PEX, lagged at penetrations.
- DWV: PVC in standard sizes with swept junctions.
- Sleeves & collars: rigid sleeves for penetrations; termite collars integrated with the moisture barrier.
- Moisture barrier: 200 µm+ vapour barrier, taped laps, tight to penetrations.
- Reinforcing: wire mesh and bar organised so they can’t pinch or displace pipes during the concrete pour.
- Waste pump (if needed): specified sump, venting, power point, backflow considerations, and maintenance access.
Slab Inspection Checklists

Testing & documentation
- Water pressure test: cap outlets, pressurise to spec, observe for drops—record time, reading, and temperature.
- DWV test: per standard method (water test or approved alternative). Record levels over time.
- As-builts: mark photos with room names, measurements to gridlines or walls.
- Certificates: obtain the plumbing compliance certificate from your professional plumber; file it with inspection sign-offs.
- Defect logs: anything found is logged with a fix date—don’t rely on memory after the slab cures.
Best practices on site (that save you headaches later)
- Hold points: make testing and photo capture a formal hold point before pour.
- Red tags: visibly tag penetrations that are out of tolerance; don’t pour until resolved.
- Communication: foreman, plumber, concreter meet on the slab edge before trucks roll. The first step is alignment.
- Protection: cap every stub; double-check sleeves; protect the moisture barrier from tears.
- Future-proofing: take wide-angle photos of every wall line with a measuring tape laid on the ground—this helps later when someone wants to core drill.
- Escalation: if suspected clash or test failure shows, stop and call the professional plumber—don’t bury a problem.
Common issues & practical fixes
1) Flat spots on waste lines (very common)
Symptoms: slow drains, gurgling, or recurring blockages soon after you move in.
Fix: confirm the falls with a CCTV camera and water testing, then re-grade the run if it’s accessible. If it isn’t, talk to your plumber about a targeted reroute or a localised slab cut, with structural advice.
2) Slab leaks on water pipes
Symptoms: unexplained moisture or warm spots on the floor.
Fix: isolate zones with pressure tests, then locate the leak with acoustic, CCTV or thermal tools. Repair often means rerouting the line above the slab.
3) Tree roots in an existing sewer connection
Symptoms: frequent blockages that get worse after rain.
Fix: root cutting and a CCTV check. If you’re tying into an old sewer line, epoxy pipe liners can rehabilitate some pipe materials and lengths. They’re not for new work under the slab.
4) Damaged moisture barrier
Symptoms: rising damp, odour, or termites finding a way in.
Fix: patch and tape the barrier before the pour. Once the slab has cured, fixes are harder and far more expensive.
5) Poor coordination with reinforcing
Symptoms: noise or vibration in fixtures, or penetrations blocked or knocked out of place during the pour.
Fix: re-check clearances, tie back the mesh and re-brace penetrations before the trucks arrive.
Under-slab success is simple: plan well, test early, keep the pour calm and document everything. Most problems come from skipping pre-pour inspections or ignoring small signs like a wobbly penetration or a suspect fall. If anything seems off after the pour (slow drains, damp patches or an uneven floor), get your plumber to pressure-test, run a camera through and advise on targeted fixes.
FAQs
1) What’s the first thing to check before a slab pour?
That pre-pour inspections are complete.
2) How much fall do waste lines need?
Under AS/NZS 3500.2 the usual minimum for a 100 mm drain is 1.65% (about 1 in 60). What matters most is a consistent grade with no bellies (dips). Ask your plumber what grade they’ve used and check it with a level before the pour.
3) Do I really need sleeves around water pipes?
Yes. Sleeves/lagging where water lines cross thickenings or movement areas prevent abrasion and protect against slab movement.
4) We poured and now have low water pressure. What happened?
A pinched or kinked supply line can drop water pressure. Isolate circuits, test, and get your plumber to locate and repair it.
5) What causes an uneven floor after the slab cures?
Sometimes it’s just finishing tolerance. But it can hint at displacement or settlement underneath, so get it checked, especially if plumbing is nearby.
6) When is a waste pump used?
Where fixtures sit below the sewer invert (the lowest point inside the sewer pipe) or gravity falls aren’t possible, a waste pump lifts wastewater up to the sewer line.
7) How do I document everything properly?
Record tests with readings and times, take labelled photos, keep the plumbing compliance certificate, and keep as-built measurements.
8) Who signs off on plumbing before we pour?
In Queensland, in-ground sanitary drainage is permit work, and council’s plumbing inspector usually inspects and tests it before it’s covered. Your builder and plumber should also confirm it matches the plans. Ask to see the inspection result before the pour.
