Agile project management is the darling of the software world, and every so often someone asks whether it would make building a house faster or better. The short answer: it works well while you're designing, and it gets expensive the moment you sign a building contract.
Here's why, and how to use the good bits without paying for the bad.
What agile actually is
Agile breaks a project into short cycles (usually called sprints) of one to four weeks. At the end of each cycle the team reviews what's been done, gets feedback from the client and reshuffles priorities for the next round. Requirements aren't locked in at the start. They emerge as the project goes.

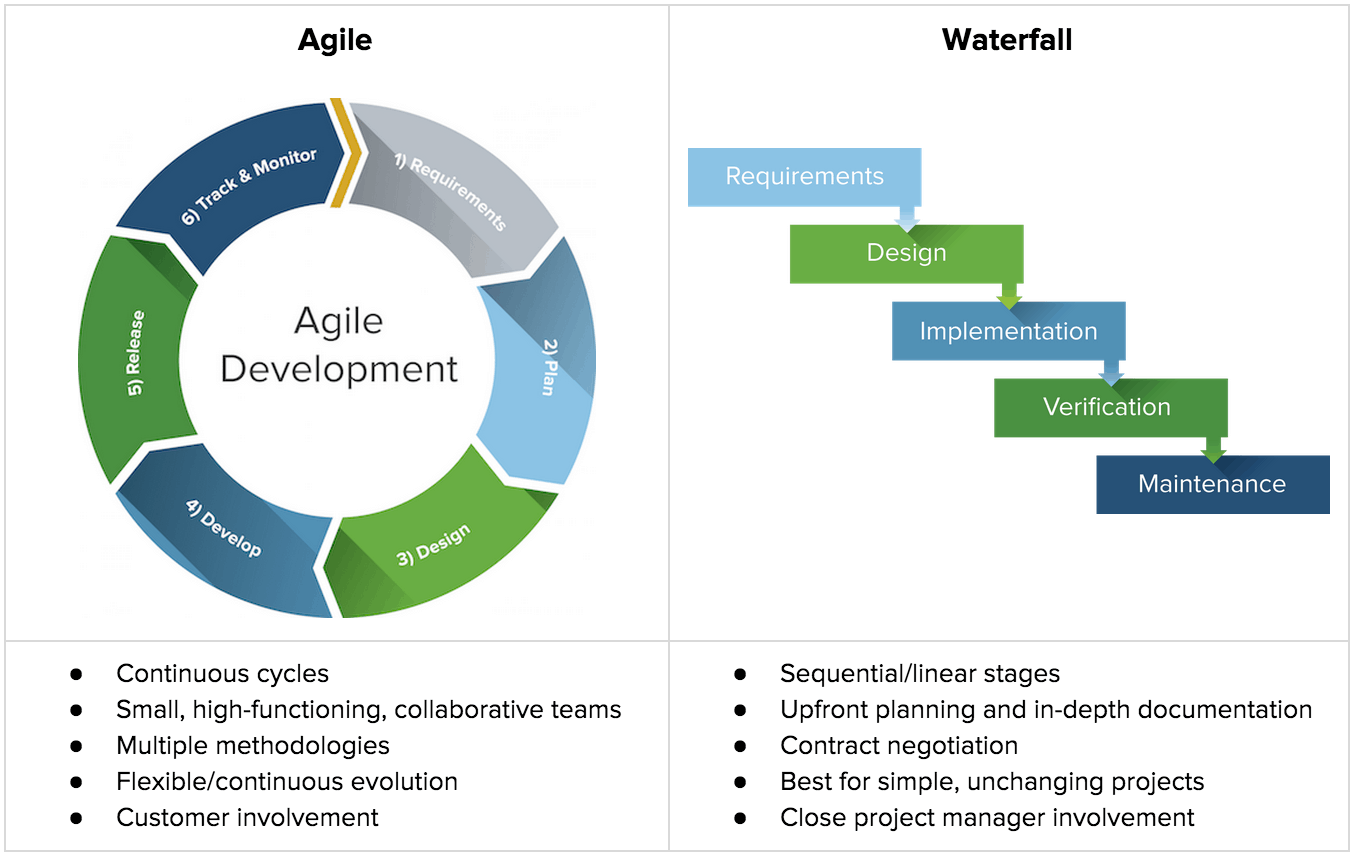

Traditional project management (often called waterfall) does the opposite. You define the scope, design, budget and program up front, then deliver it in sequence. Changes are possible, but they're managed formally.
Why software and houses are different
In software, a change usually costs a bit of time. Nothing physical is torn out. You can release a working version, test it and improve it next sprint.
A house doesn't work like that:
- Work is sequential. You can't frame before the slab, or line walls before the rough-in. Each trade depends on the one before.
- Materials are ordered in advance. Windows, trusses, cabinetry and stone often have lead times of weeks, and they're made to measure.
- Approvals are fixed. Your building approval is based on specific plans. Change the structure or the layout and you may need an amended approval.
- Changes cost real money. Moving a wall after the frame is up means a new frame, new rough-in and wasted materials.
- There's a hard finish. Software keeps releasing updates. A house has practical completion and handover.
The contract is the key point
Under a fixed-price Queensland building contract, such as the QBCC New Home Construction Contract, every change you make after signing is a variation. A variation has to be agreed in writing and it usually comes with a cost, a builder's margin and often an extension of time.
So "let's decide the kitchen layout once we see the frame" isn't agile. It's a variation, and you'll pay for it. Our guide to residential building variations explains how they work.
In a house, true agile delivery would mean finalising one room's selections at a time. That only really works before contract, or with a cost-plus arrangement where you pay actual costs plus a margin and carry the risk of the final price.
Where agile does help: the design phase
Design is where flexibility is cheap. Changing a line on a drawing costs very little. Changing it on site costs a lot. During design you can borrow the best of agile:
- Short, regular design reviews with your designer or architect, every week or two.
- Feedback early and often. Walk through the plans room by room. Picture where the furniture goes, where the sun comes in and how you'll actually use each space.
- Prioritise. Make a list of must-haves and nice-to-haves, so when the budget bites you know what to drop.
- Test ideas cheaply. Visit display homes, mark out rooms on the ground, use 3D models.
Our C20 Design Your New Home checklist walks you through the decisions to make at this stage.
Where traditional methods win: the build
Once you're on site, you want certainty, not iteration:
- A selections deadline before contract. Lock in finishes, fixtures and appliances so the price is real and nothing is left as a vague allowance.
- A clear program with the major milestones.
- Stage-gate inspections. Check the work at each stage (slab, frame, enclosed, fixing, practical completion) before the next trade covers it up. See our post on stage gates and ITPs.
There is one agile habit worth keeping during the build: short, regular check-ins. A quick weekly update from your builder on progress, issues and what's coming next catches problems early. That's just good communication.
The bottom line
Be agile during design, then lock the scope before you sign. Change your mind as much as you like while it's still on paper. Once the contract is signed and the trucks start arriving, every change has a price tag.
If you want to stay agile (pun fully intended), do it with a pencil, not a crowbar.
